HDI PCBs use small interconnections and fine routing features to fit more connections into a limited area. Specifying one requires more than writing “HDI” on a purchase order: the fabricator needs an agreed construction, material requirements, via details and acceptance plan. A board that passes an electrical connectivity test has not automatically demonstrated long-term reliability.
For an engineer or buyer reviewing an HDI order, the practical question is whether the manufacturing and test evidence applies to the board being purchased. This guide explains what to specify, what different checks can show, and how to review a production lot without treating a generic certificate as proof of every requirement.

What Makes an HDI PCB Different to Specify?
HDI describes interconnection density, not a guaranteed performance level. Smaller features allow more routing in a confined area, but they also make the relationship between the design and the manufacturing process more important.

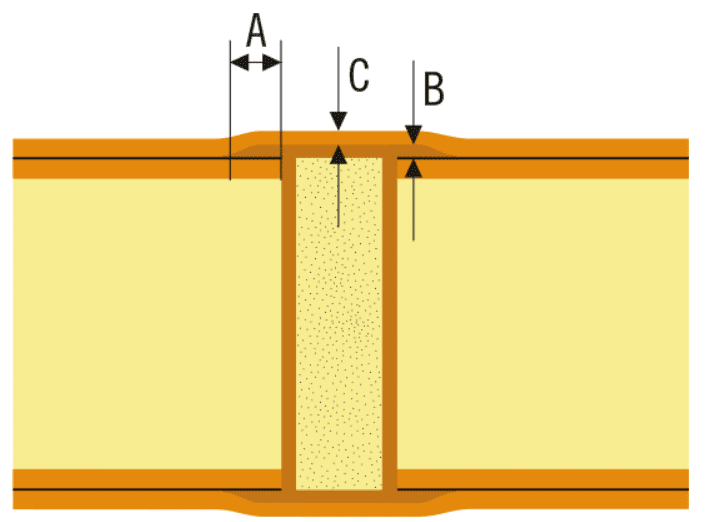

A microvia is a small connection between nearby conductive layers. Its geometry, the dielectric it passes through and its copper interfaces must work together. The same finished board thickness can hide very different internal constructions. A high layer count alone does not establish that a board is HDI, and not every HDI board uses an any-layer structure.
Keep three questions separate: what connects to what, what materials form the board, and how the construction is made and verified. “HDI” does not answer all three. FR-4 and HDI are not opposing categories: one concerns a material family and the other concerns interconnection technology. The actual laminate system still needs selection for the application and process.
For layer notation and routing geometry, use the separate HDI PCB design guide. Here, the focus is the information and evidence needed after a proposed design moves toward fabrication.
Turn the Design into Manufacturing Requirements
A useful manufacturing specification identifies the required result and resolves anything the supplier would otherwise have to guess. Freeze that information with the fabrication data before accepting a quotation as the basis for production.
| Requirement | Information to agree | What an incomplete request can hide |
|---|---|---|
| Construction | Layer order, layer functions, dielectric thicknesses and each required via connection | Two proposals with the same layer count but different internal routes or processing needs |
| Materials | Specified laminate/prepreg system, relevant properties and permitted substitutions | A material change that affects processing or electrical behavior |

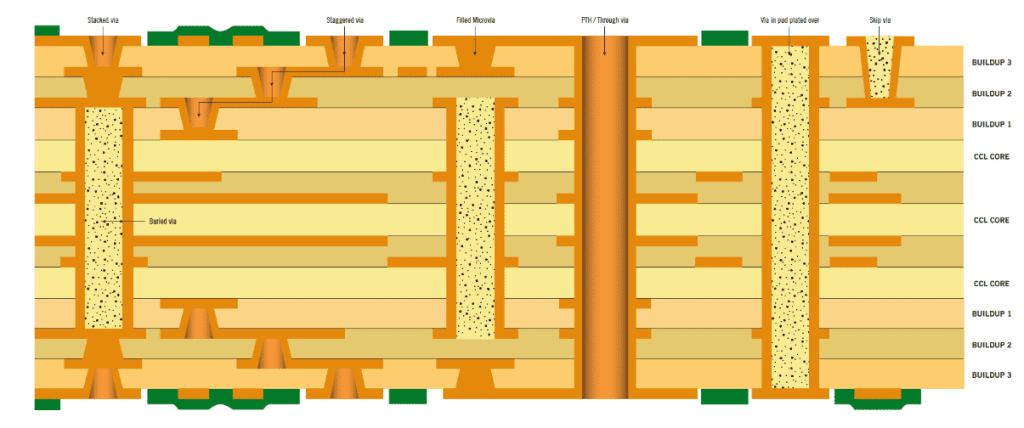

| Via geometry and treatment | Layer spans, pad geometry, filling and capping requirements, and stacked or staggered arrangement where applicable | A hole drawing that does not define the finished connection or surface condition |
| Conductors and impedance | Finished copper requirements, controlled dimensions, impedance targets and tolerances where needed | A nominal line width interpreted without its actual dielectric and copper context |
| Assembly exposure | Expected assembly thermal history and any planned rework limits or special handling requirements | A bare-board acceptance plan that ignores the next manufacturing stage |
| Acceptance | Applicable specification, revision, class, test methods, sampling, limits and required reports | “IPC compliant” without an agreed scope or an identifiable set of criteria |
Do not combine a minimum hole size from one capability sheet with a minimum dielectric thickness from another and assume the combination is qualified. Ask the selected fabricator to review the actual combination. Its routine production capability may differ from a development limit achieved on a special sample.
NCAB’s HDI technical guidance connects dielectric thickness and microvia geometry with manufacturing risks. Such supplier guidance is useful for asking better questions, but its numbers are not automatically another factory’s process limits or your product’s acceptance criteria.
Close technical questions in writing. If the fabricator proposes a material substitution or via change, identify the affected drawing and obtain the required engineering approval before production. An email saying “equivalent” is not a definition of which properties and processes remain equivalent.

Understand What Each Inspection or Test Can Prove
Different checks answer different questions. Use their results together, and do not ask one test to prove something outside its scope.
| Check | Useful evidence | Important limitation |
|---|---|---|
| Visual inspection | Visible workmanship, surface damage and features accessible to the inspection method | Cannot establish the integrity of every hidden interface |
| Bare-board netlist electrical test | Required connectivity and isolation under the specified test conditions | Does not by itself demonstrate behavior throughout later thermal exposure or service |
| Microsection examination | Local construction and selected geometric or plating features in the sectioned sample | A destructive sample is not a view of every via on every board |
| Thermal-stress testing with resistance monitoring | Electrical behavior of the represented via structure during the agreed stress sequence | Its relevance depends on the specimen, monitoring method, conditions and acceptance limits |
| Assembled-board functional test | Operation of the tested functions in the defined setup | May not exercise every connection or represent the complete service environment |
In a 2019 microvia reliability warning, IPC described failures that appeared after conventional bare-board acceptance and highlighted limitations of traditional microsection inspection alone. This is historical guidance explaining why test scope matters, not a statement that all present-day HDI boards are unreliable or a substitute for the applicable current specification.
In plain language, a connection may conduct when tested at room temperature but behave differently during heating. A result taken only before or after stress does not necessarily describe what happened during it. Ask when measurements were taken and what the approved method requires. Do not invent a universal resistance-change limit or thermal profile from an article.
Reading a percentage example: suppose a reported chain resistance changes from 1.00 Ω to 1.08 Ω. The change is (1.08 − 1.00) ÷ 1.00 × 100 = 8%. This hypothetical calculation explains the number only. Whether it passes depends on the specified method, temperature conditions, instrumentation and agreed limit. An 8% result is not automatically acceptable or unacceptable.
Match Reliability Evidence to the Actual Construction
Reliability evidence is useful only when you know what was tested and why it represents the construction under review. A report for a different via arrangement cannot be treated as direct proof for yours without a documented technical justification.
A test coupon is a purpose-designed test pattern, often associated with a fabrication panel. It can make selected structures accessible for measurement or destructive examination. It is not automatically representative just because it was supplied with a board: check its construction, location or traceability, and the feature it is intended to evaluate.
- Identify the structure: does the specimen represent the relevant layer transitions, via arrangement and material system?
- Identify the process: was it made using the relevant production route, or is it a historical demonstration of a different process?
- Identify the exposure: what preparation, thermal sequence and measurement conditions were applied?
- Identify the decision rule: what constitutes a failure, and who approved that criterion?
- Identify the data: does the report include measured results, sample identification and exceptions rather than only a pass stamp?
Separate qualification from lot acceptance. Qualification asks whether a defined construction or process has demonstrated suitability against a test plan. Lot acceptance asks whether the supplied production lot meets the agreed delivery requirements. Neither term should be used without explaining its scope. A qualification report from last year may be relevant background, but it is not the same record as this lot’s acceptance results.
A hypothetical report comparison: Supplier A offers a general microvia qualification summary with no construction drawing. Supplier B identifies the tested via arrangement, material, process revision and test conditions, and explains how these relate to the proposed board. B provides more reviewable evidence, but it still needs comparison with the actual order. Neither supplier should receive automatic approval solely because its cover sheet says “passed.”
When the proposed board differs from the tested specimen, ask what changed and whether additional evaluation is needed. Do not assume a more complex specimen automatically covers every simpler design, or that a smaller hole is simply a scaled version of a previously qualified connection.
Review the Lot Before Accepting Delivery
Review the delivered records against the agreed order, not against a generic checklist alone. Resolve missing evidence and unapproved deviations before the lot enters assembly.
- Match identity and revision. Compare board part number, fabrication revision, lot identification and quantity with the purchase order and released data. Separate old and new revisions so their records cannot be mixed.
- Confirm the approved construction. Check the final stackup, material identification and recorded changes. Ask for clarification if a report references a different drawing or process revision.
- Check the required inspection and test records. Verify that specified tests were performed, results are attached, specimen identities are traceable and acceptance criteria match the order.
- Read exceptions as carefully as passes. Review retests, anomalous measurements, concessions and rework. Establish who approved a deviation and whether that approval covers this lot.
- Confirm handling information. Review packaging, storage and any assembly preparation instructions against the material and supplier requirements. Do not apply a generic baking instruction without checking compatibility.
- Record the disposition. Document acceptance, conditional acceptance under an authorized concession, or a hold pending clarification. Keep the decision and supporting evidence with the lot record.
For an engineering sample, the decision may be to proceed with a defined evaluation rather than release it as production-qualified hardware. Make that distinction visible to the assembly and test teams. A prototype that functions once does not establish production consistency.
Cost comparisons should use the same requirements. A cheaper quote may exclude a report, use a different construction or assume a different sampling plan. Ask each supplier to list inclusions and exclusions. There is no defensible universal percentage by which every added HDI build-up level increases the final price; the actual design, volume, process and verification scope matter.
Keep a reusable handoff package: released fabrication data, final stackup, via requirements, material restrictions, impedance requirements where applicable, relevant assembly conditions, agreed acceptance plan and the list of deliverable records. This is more useful than asking for “high-quality HDI” without defining how quality will be judged.
HDI PCB Manufacturing Questions
Does an HDI PCB have to use a non-FR-4 material?
No. HDI is an interconnection approach, not the name of a laminate. Select a suitable material system for the electrical, thermal and fabrication requirements, and confirm the proposed construction with the fabricator.

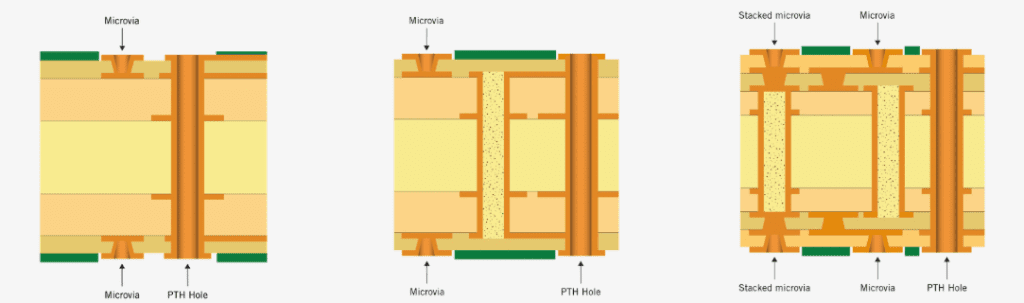

Are stacked microvias always unacceptable?
No universal rejection follows from the word “stacked.” Review the specific structure, manufacturing process and applicable evidence. Conversely, do not assume a structure is reliable just because it is offered on a capability list.
Does a netlist test replace reliability testing?
No. It addresses connectivity and isolation under its specified conditions. A reliability evaluation addresses behavior under a defined exposure or operating context. Agree the required checks before production.
Is a microsection photograph enough to accept a lot?
It can support specified local construction checks, but it cannot show every connection or establish every reliability requirement. Review it alongside the other evidence required by the acceptance plan.
What does “IPC compliant” need to include?
Ask which specification, revision and class apply, which product requirements are covered, and what agreed exceptions exist. The phrase alone does not identify a complete acceptance plan.
Can a material substitution be approved after fabrication?
It requires the appropriate engineering and contractual review; it should not be treated as routine paperwork. Define allowed substitutions and approval responsibilities before manufacturing to avoid receiving an unreviewed construction.
How many reflow cycles should the board withstand?
Define the relevant assembly history and qualification requirements for the product. There is no single number that this general guide can safely apply to every HDI construction. Ask for the approved profile, exposure sequence and evidence supporting it.
What should I send when requesting an HDI quotation?
Send the fabrication files and revision, stackup, via details, material and finish requirements, quantity, impedance needs and requested acceptance records. Include relevant assembly conditions and flag unresolved technical questions instead of leaving the supplier to guess.
For an HDI manufacturing discussion, contact PCBtry with this package and ask which construction and verification requirements can be supported. Confirm the scope, any proposed changes and the required deliverables before authorizing production.
